MOC-Agave Battery Storage Facility & Substation
Arizona
Project Overview
PCS Pads Installed
47
Conduit Installed
15,000 LF
Concrete Poured
2,000+ CY
Project Duration
12/2024-3/2025
Completed
2025
Client
Arizona Public Service
Location
Tonopah, AZ
Market
Services
Utility-Scale Battery Storage Facility & Substation Civil Infrastructure Development

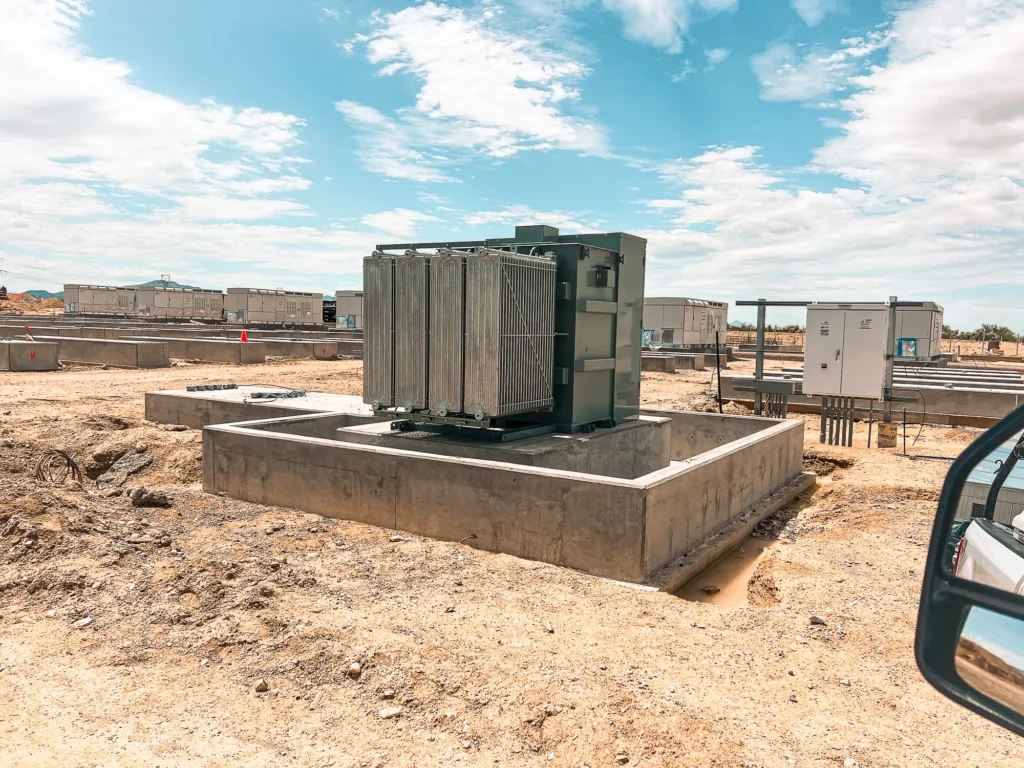

A high-profile site development project for a new utility-scale battery storage facility and associated substation. The scope included extensive civil and electrical infrastructure work, with over 2,000 CY of concrete placed for equipment pads, foundations, and associated structures.

Full Scope of Work
Civil & Foundation Work

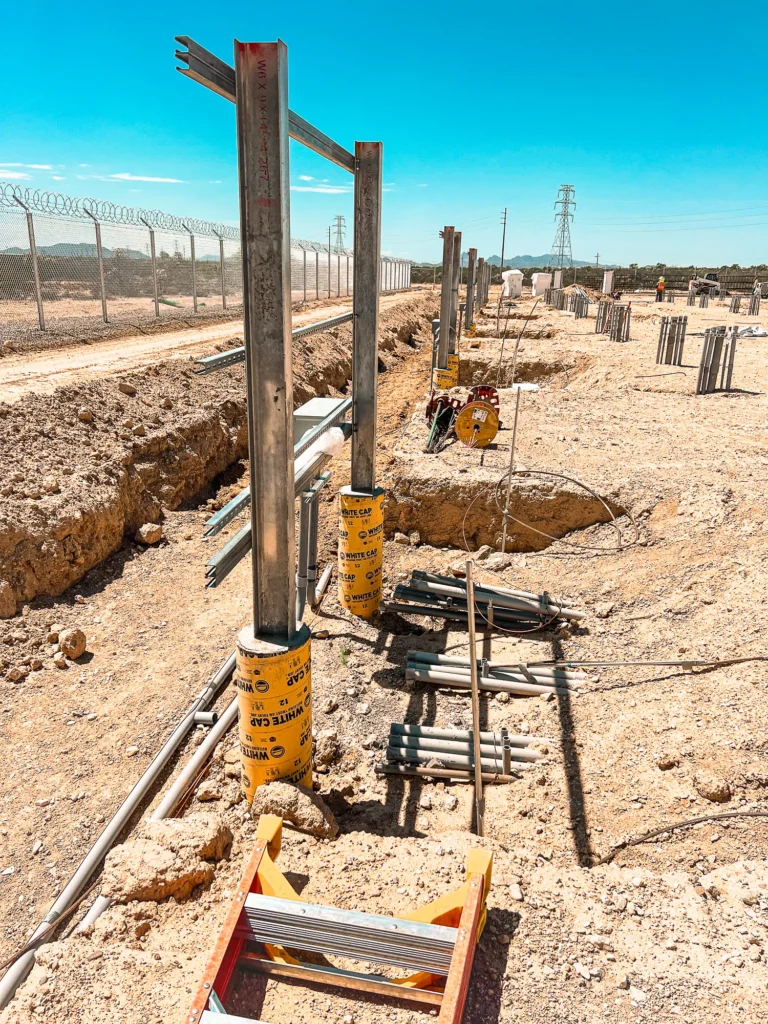

- 47 PCS equipment pads installed to support battery storage units

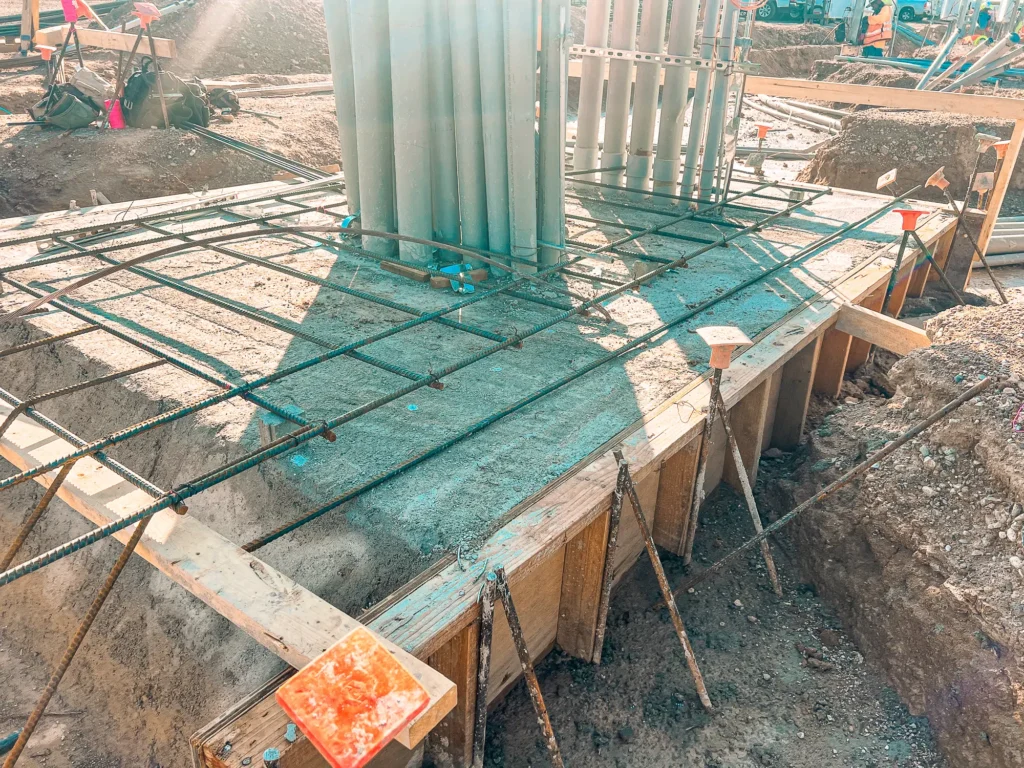

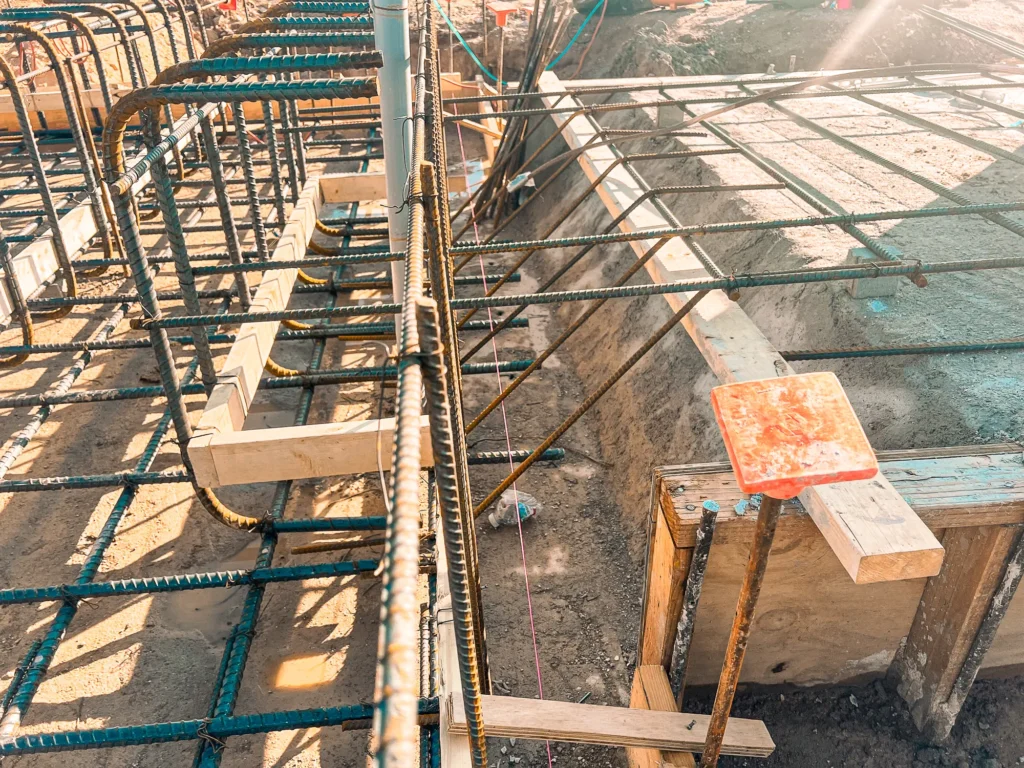

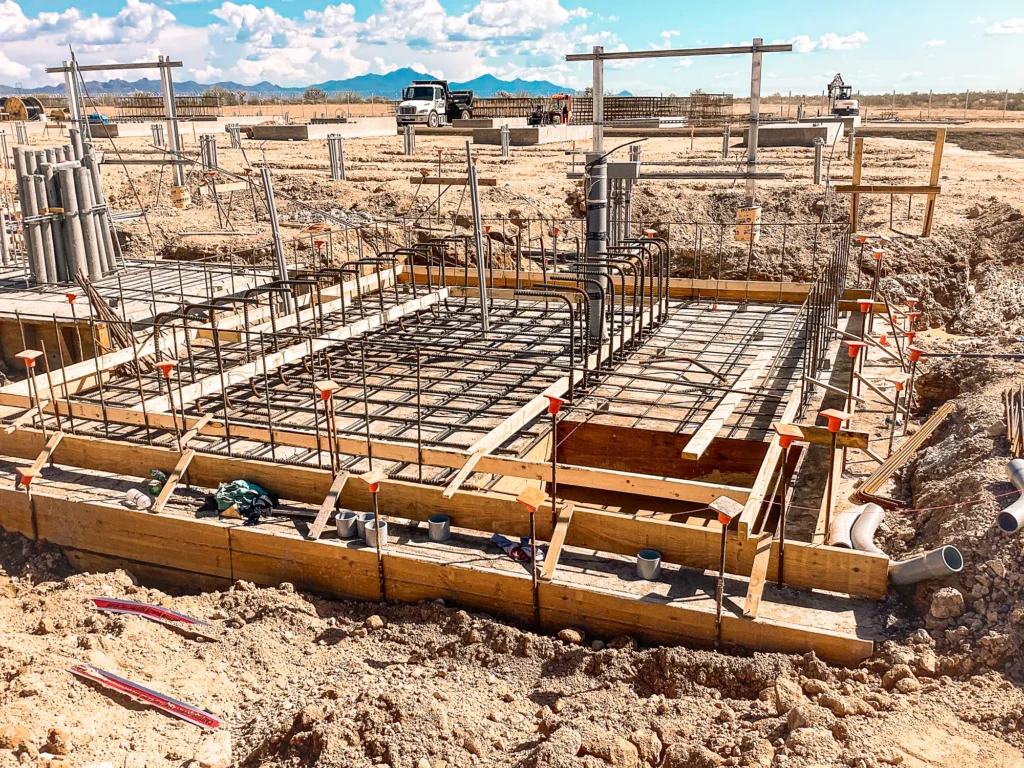

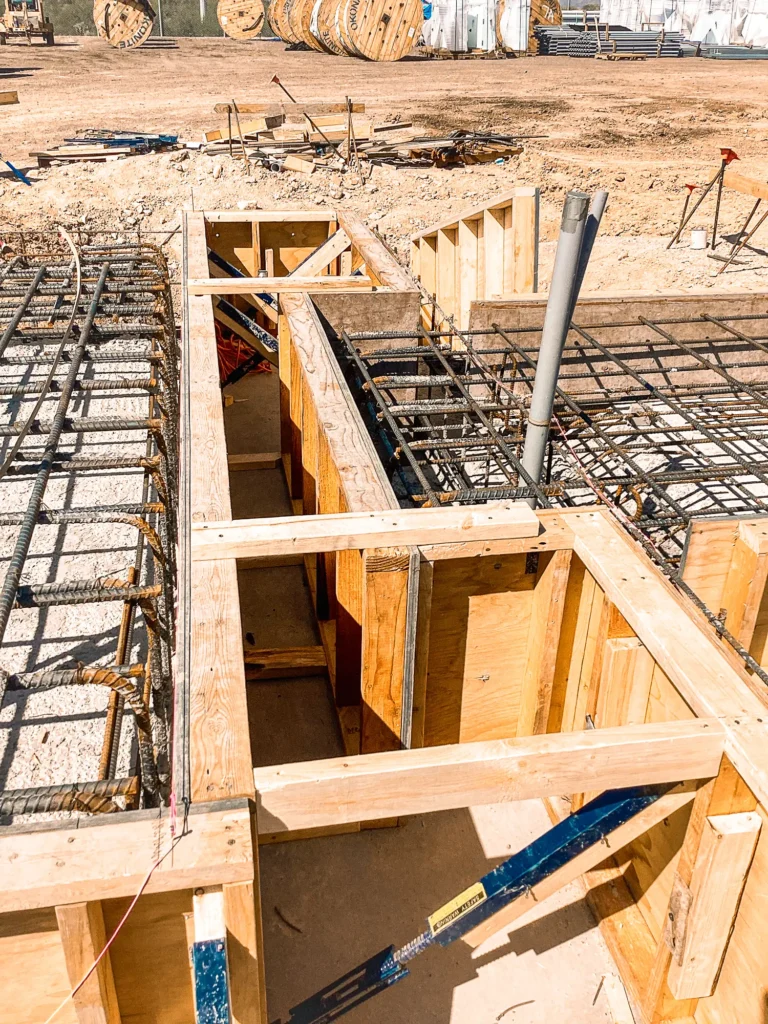

- Over 1,200 CY of concrete poured for pads, foundations, and structural elements
- Excavation and spoils management in compliance with site environmental controls
Electrical Infrastructure

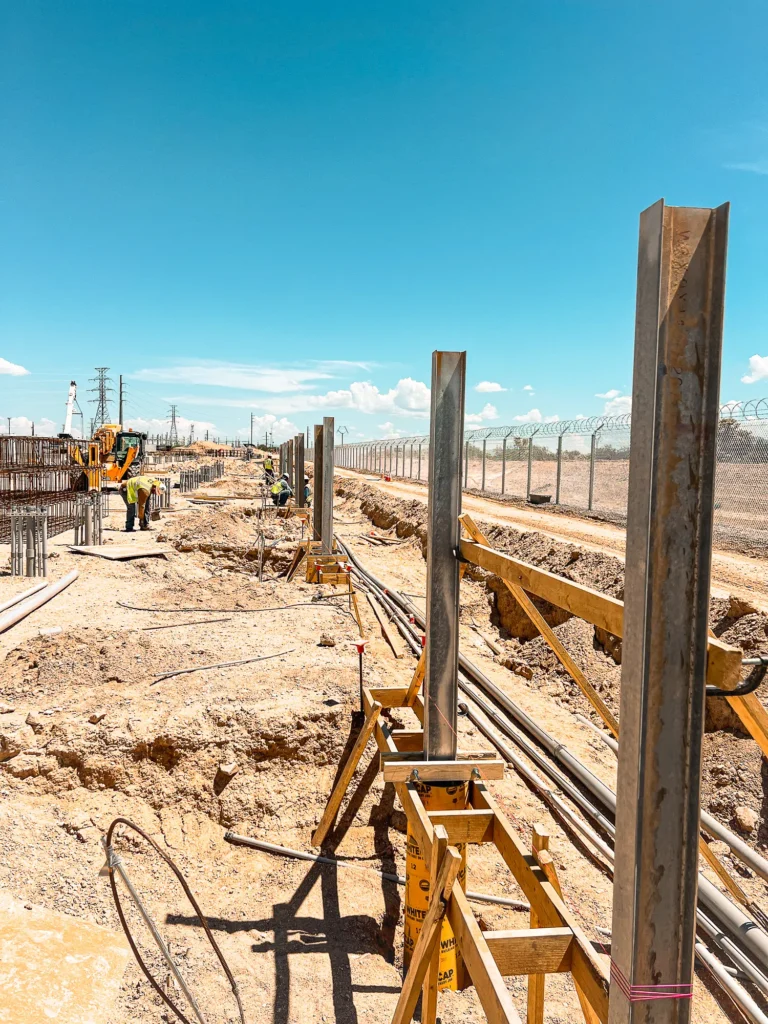

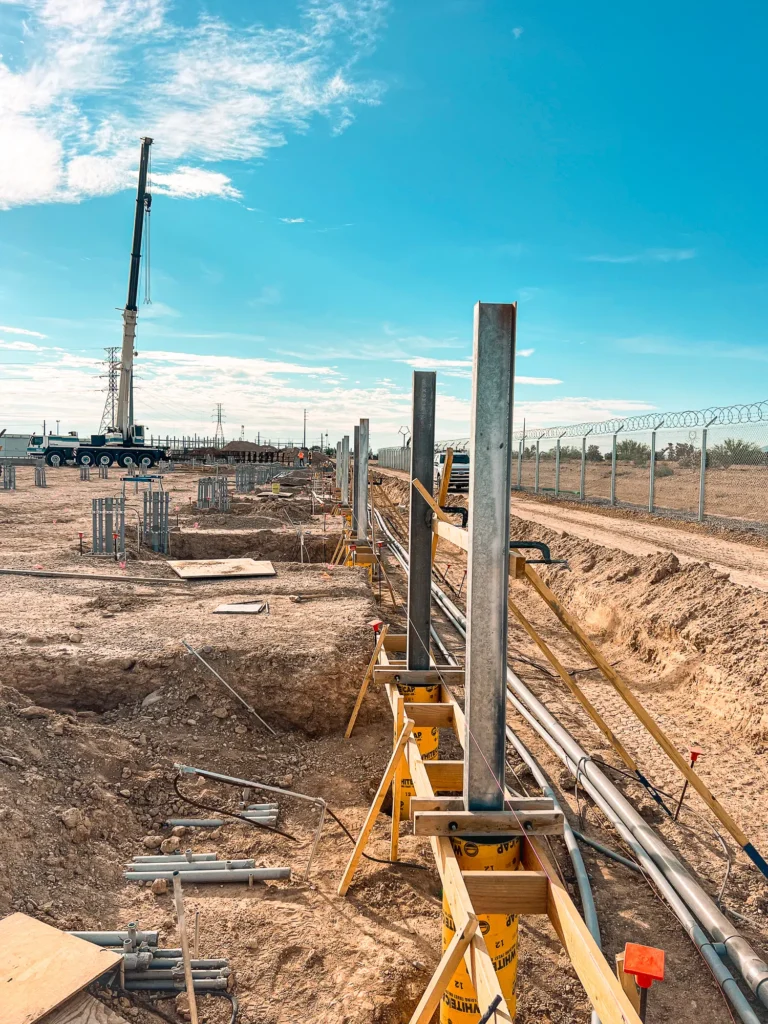

- 15,000 LF of electrical conduit installed across the facility
- 50 light standards installed for site security and operational lighting

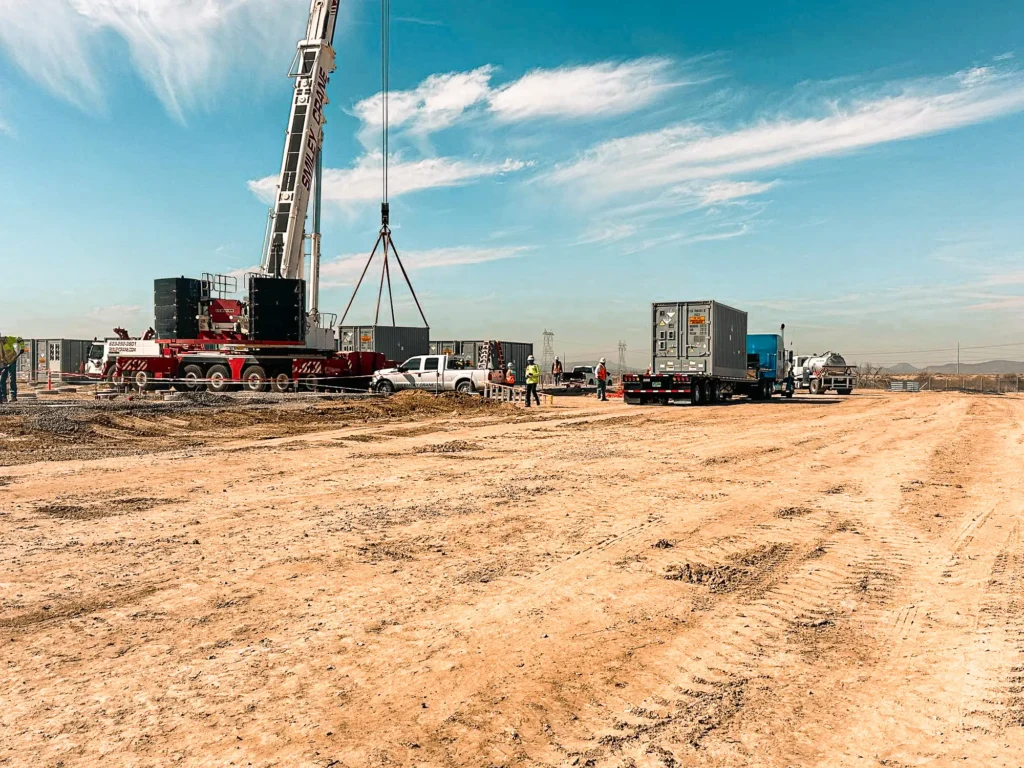

- Conduit routing coordinated with substation electrical design team
Site Development

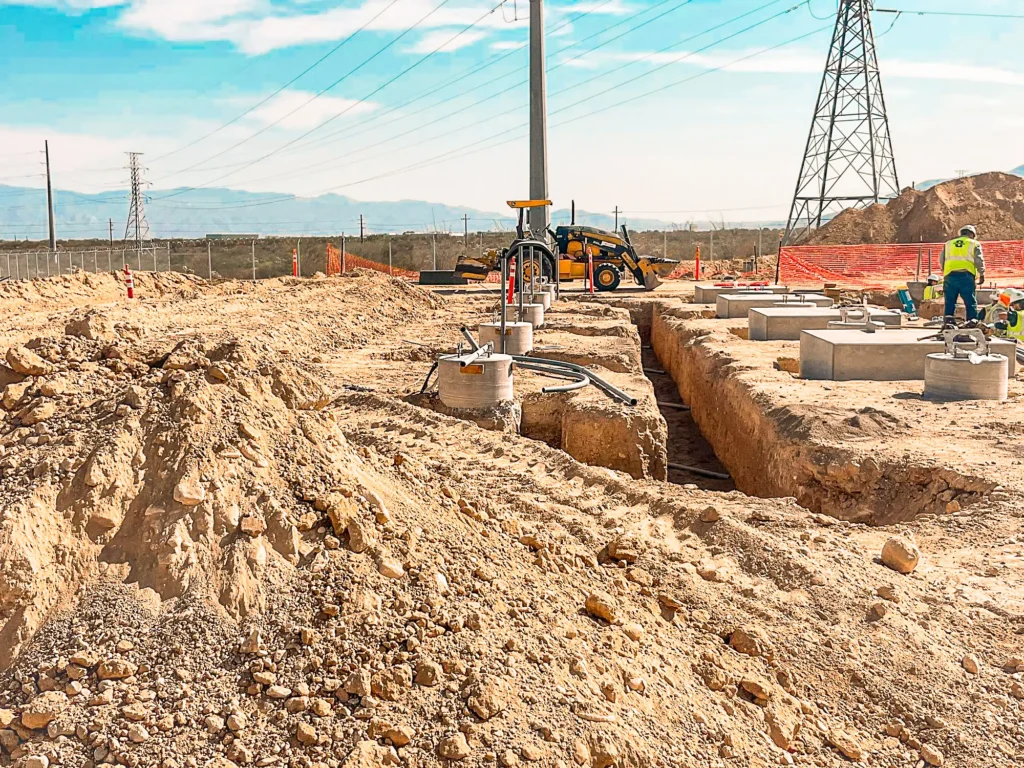

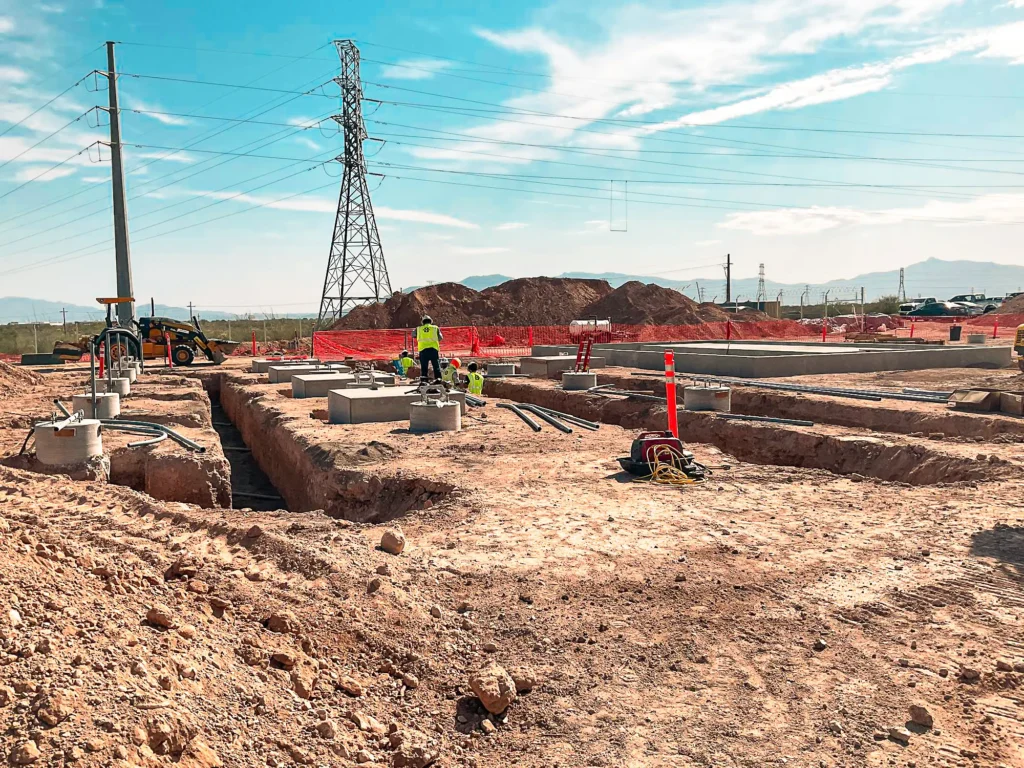

- Substation and battery storage area grading and site preparation
- Excavation spoils management and off-site disposal coordination
- Site work coordinated with equipment procurement and energization schedule
